August 17, 2026
Hemanth Velury
CEO & Co-FounderAlmost everything written about residential design stops at approval. The client says yes, the drawings are issued, and the story ends.

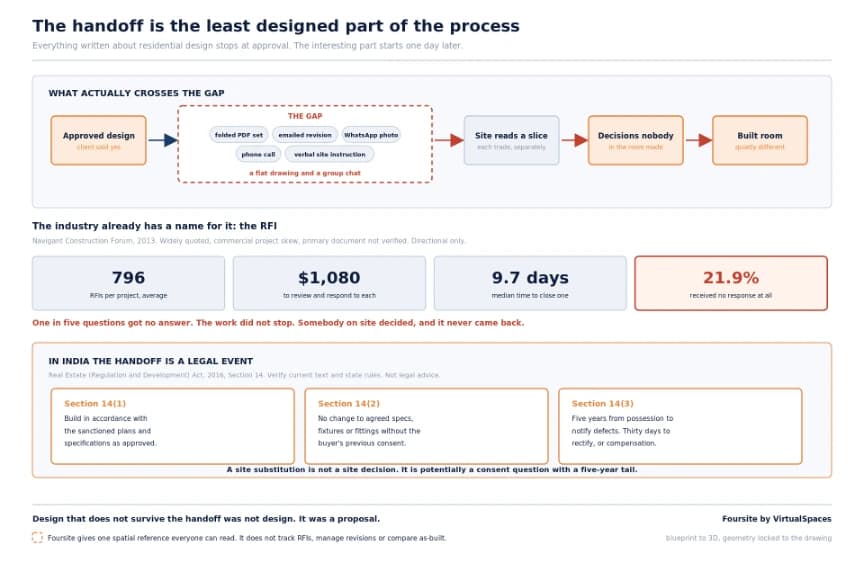

The interesting part starts one day later.
Because between an approved design and a finished home there is a handoff, and it is the least designed part of the entire process. A set of drawings goes to a contractor. A site engineer reads them. A carpenter, a tiler, a plumber and an electrician each interpret a slice. Somewhere in that chain, decisions get made that nobody in the design meeting made, and the built room quietly stops matching the room that was approved.
Not dramatically. Nobody builds the wrong house. But the socket moves 400 mm because a beam was in the way. The tile layout starts from the wrong corner. The false ceiling drops 100 mm lower than drawn to clear a duct. The specified fitting was out of stock, so a similar one went in.
Each is defensible alone. Together they are the difference between the home that was designed and the home that exists.
Ask what physically travels from design to site on a typical residential project, and the honest answer is uncomfortable:
A PDF drawing set, printed, folded, and carried around a dusty site
A revision issued by email that may or may not have reached the person cutting the tile
Photographs on WhatsApp, with questions attached
A phone call
A verbal instruction on a site walk, sometimes written into a site instruction register afterwards, sometimes not
A sample or a mock-up, if the project is large enough to afford one
That is the interface. Between a design worth lakhs or millions and a building that will stand for decades, the medium is a flat drawing and a group chat.
The gap is not skill. Site teams are often extremely good. The gap is that the design was produced in a representation the site cannot fully interrogate, while the site works in a reality the design never fully described.
Construction already has a name for this. The RFI, or request for information, is a formal question from the site asking what the drawings did not answer.
The most widely quoted research on this is a 2013 Navigant Construction Forum study, repeated across the industry ever since. It analyzed 1,362 projects containing more than one million RFIs, and reported an average of 796 RFIs per project, an average cost of about $1,080 to review and respond to each one, roughly $860,000 of professional time on a single job, a median of 9.7 days to close one out, an average first response of 6.4 days, and about 21.9% receiving no response at all.
A caveat before anyone quotes those numbers back at me. The study is from 2013, and its projects skew larger and more commercial than a residential fit-out. I would defend their internal consistency: 796 RFIs at about $1,080 each lands near the $860,000 quoted.
The number I would actually hang an argument on is the last one. Roughly one in five questions from site got no answer.
The work does not stop when that happens. Somebody on site makes the call. That decision never returns to the design team, never reaches the client, and surfaces at snagging or after handover.
I am not going to give you a rework cost figure, for the same reason I refused to in an earlier article: the industry disagrees with itself by more than an order of magnitude. The commonly quoted 5% of project cost is contested, and an American Society of Civil Engineers technical note from January 2026, covering a study of a contractor's actual records, put precompletion rework at approximately 0.38% of contract value and about 0.76% including postcompletion corrections. If someone sells you a handoff tool on a rework percentage, ask which study.

Five structural reasons, none of which are anybody's fault:
A drawing is a projection, not the thing. Plans, sections and elevations are slices. Reading them well is a professional skill, and the tradespeople executing the work often read only their slice.
Different trades read different drawings. The electrical layout, the plumbing layout, the ceiling plan and the tiling layout are separate documents. Clashes between them are discovered by whoever gets there second, usually with a hammer.
Revisions travel worse than originals. The first issue reaches everyone. Revision C reaches whoever was on the email.
Site conditions differ from drawing conditions. Real walls are not perfectly square, real slabs are not perfectly level, real beams are not always where the structural drawing suggested.
The client is absent. The one person who most cares whether the built room matches the approved room is the one person not on site, and they cannot read the drawings anyway.
Most markets treat the handoff as a project-management problem. India made it a statutory one, and I think that is underappreciated.
Section 14 of the Real Estate (Regulation and Development) Act, 2016 is titled "Adherence to sanctioned plans and project specifications by the promoter." Three things in it matter here.
Section 14(1) requires that the project be developed and completed in accordance with the sanctioned plans, layout plans and specifications approved by the competent authorities. Build what was sanctioned.
Section 14(2) goes further. Once the sanctioned plans, specifications and the nature of the fixtures, fittings, amenities and common areas have been disclosed to the buyer, the promoter cannot make additions or alterations to them for that apartment without that buyer's previous consent. There is a proviso for minor changes, including those necessary for architectural or structural reasons when recommended and verified by an authorised architect or engineer, with declaration and intimation to the buyer. But the Act then defines what "minor" excludes, and the list is long: structural change, addition to area, change in height, removal of part of a building, construction or removal or cutting into any wall or part of a wall, partition, column, beam, joist or floor including a mezzanine, changing or closing any required means of access, ingress or egress, and a change to the fixtures or equipment. For alterations to the building or common areas more broadly, Section 14(2)(ii) requires the previous written consent of at least two-thirds of the allottees.
Section 14(3) attaches a tail. If a structural defect, or any other defect in workmanship, quality or provision of services, or any other obligation of the promoter under the agreement for sale, is brought to the promoter's notice within five years of possession, the promoter must rectify it without further charge within thirty days, failing which the buyer is entitled to compensation under the Act.
Read those together and the picture is stark. In India, a change made on site to a fixture, a wall or a specification is not a site decision. It is potentially a consent question, and it carries a five-year liability tail with a thirty-day clock on rectification.
And the mechanism for controlling all of that is still a PDF, a WhatsApp photo and a site instruction register.
I am not a lawyer and this is not legal advice. State rules under RERA vary, and you should check the current text and your state's rules before relying on any of it commercially. But the direction is not ambiguous: the cost of the built room not matching the agreed room went up in 2017 and has stayed up.
Worth saying plainly, because a lot of technology marketing implies otherwise.
Site teams deviate for good reasons most of the time. A duct is where the drawing did not show it. A specified material has a twelve-week lead time and the handover date will not move. A wall came out 30 mm off and something has to absorb it. Competent people solving real problems in real time with incomplete information.
The failure is not the deviation. It is that the deviation is invisible to everyone who would have cared, until it is permanent.
The useful shift is not "give the site an app." It is that when the design exists as accurate geometry rather than as a set of flat projections, several things become possible that were not.
| Who | The handoff problem today | What accurate geometry changes |
|---|---|---|
| Site engineers and contractors | Reading intent from separate 2D layouts, then resolving clashes physically | A single spatial reference that can be looked at from any angle, so intent is visible rather than inferred |
| Interior designers | Deviations discovered at snagging, when they are permanent | A shared visual the site can point at when asking a question, which shortens the question |
| Residential developers | The same misinterpretation repeated across every unit of a type | A layout ambiguity caught once, before it is repeated a few hundred times |
| Architects | Revisions that do not reach the person cutting the material | One current model rather than a folder of drawing versions of uncertain vintage |
| Homeowners and buyers | No way to compare the built room to the room they agreed to | A reference they can actually read, which matters a great deal under a consent regime |
That last row is the one I would underline. Under a legal framework that requires buyer consent for changes, the buyer needs to understand what they consented to. A 2D floor plan does not give them that. An accurate walkthrough does.
This is the practical argument for 2D to 3D that has nothing to do with marketing. When you convert floor plan to 3D with geometry locked to the drawing, you produce a reference a non-specialist can read. Which means the person with the most at stake can finally participate in the conversation about whether the thing being built is the thing that was agreed. Blueprint to 3D stops being a sales asset and becomes a shared language.
I would rather be trusted than persuasive, so here is the other half.
A model does not make a wall plumb. Execution quality is a site discipline and no visualization fixes it.
Tolerances are real. A built room will never match a model exactly. The useful question is what deviation is acceptable, not whether there is any.
Site conditions still surprise people. Existing structures, services and soil do not read drawings.
A model is only as current as its last update. If the design changes and the model does not, you have moved the staleness problem, not solved it.
None of this replaces supervision, mock-ups, sample approvals or a competent project manager.
AI visualization is not a construction management system, and anyone positioning it as one is overselling.
Being direct, as I have been in previous articles.
Foursite converts 2D floor plans and blueprints into accurate 3D Visualization, walkthroughs, interior design photoreal renders and AI virtual staging, with the geometry locked to the drawing rather than loosely inspired by it. That means a site team, a client and a designer can look at the same spatial reference and mean the same thing.
It is not a site management tool. It does not track RFIs, manage revisions across trades, log site instructions, or compare as-built conditions against the model. Those are not features and I am not going to imply they are. Remodroom, which redesigns an existing room from a photograph, is a renovation and decision tool, not a construction reference.
What I will argue is that the foundation for any of that is geometry that is actually right, and that is the part we have spent our time on. Plenty of AI interior design and AI interior décor tools can produce a convincing room, and plenty of AI interior decor output is fine as interior design renders for a brochure. Very few produce a room whose dimensions you could hand to a carpenter, which is the only test that matters at handoff. That gap is also why AI 3D visualization has stayed a marketing category instead of an operational one.
Things worth doing regardless of tooling:
Issue one current reference and say so. Whatever the medium, there should be an unambiguous answer to "which version is live," and everyone on site should know it.
Walk the model with the site team before work starts. Ten minutes of looking at the space together removes a surprising number of future questions.
Log every RFI and close them. The one in five that go unanswered are the ones that become permanent decisions nobody made.
Treat any change to a fixture, wall or specification as a consent question first. In India this is not optional. Elsewhere it is still good practice.
Photograph against the model, not just the drawing. A comparison a non-specialist can read is one the client can participate in.
Get the buyer to see the room, not the plan, before it is built. They cannot flag a mismatch they were never able to picture.
There is a version of our industry that treats interior design 3D visualization as the last step of selling and the first thing forgotten once construction starts. That is backwards.
A drawing is a set of instructions. The value of making it legible does not end at approval; it peaks the moment it reaches the people holding the tools. Every question answered before someone cuts something is cheaper than the same question answered after.
Design that does not survive the handoff was not design. It was a proposal.
