From Floor Plan to Bill of Materials: What a Spec-Accurate 3D Model Unlocks for Procurement

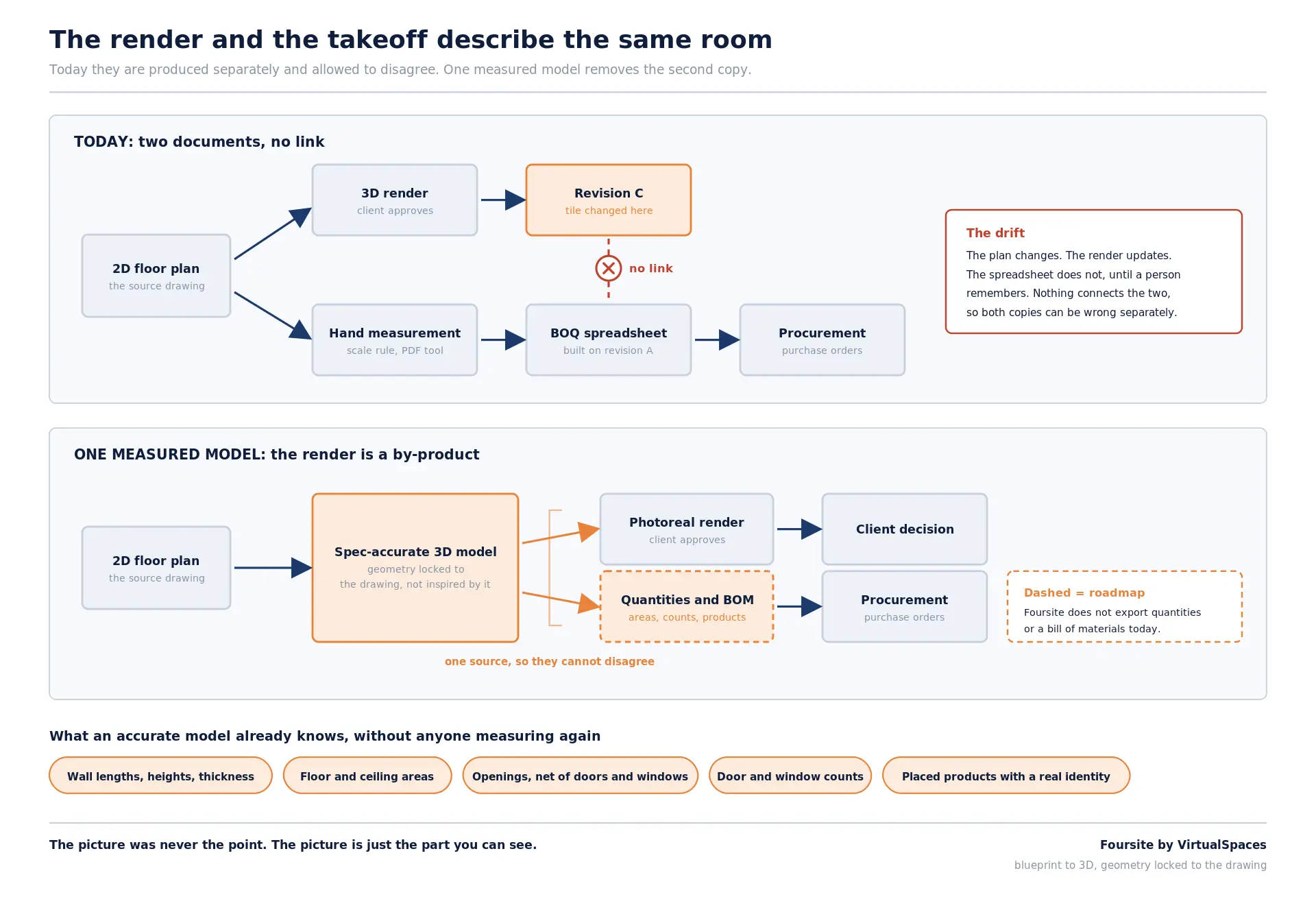

On most residential projects there are two documents describing the same room, and they never talk to each other.

The first is the visual. A set of interior design renders, a walkthrough, a board the client signs off on. It shows a specific floor finish, a specific tile, a specific run of cabinetry, a specific number of doors.

The second is the money. A takeoff, a bill of quantities, a materials list in a spreadsheet. Somebody measured it by hand off the 2D floor plans, applied a waste factor, priced it, and sent it to procurement.

Same room. Different people, different times, different files. They drift apart almost immediately: when the client changes the tile, the visual updates and the spreadsheet does not, until someone remembers.

This gap is the least glamorous and possibly the most valuable thing an accurate 3D model can close.

What is a takeoff?

If you have never sat on the cost side, here is the short version.

A quantity takeoff is the process of reading a drawing and extracting how much of everything the job needs. Square meters of flooring. Linear meters of skirting. Wall area to paint, minus openings. Counts of doors, windows and light points. Running meters of countertop. A bill of materials or bill of quantities is that list, priced.

Everything downstream depends on it: the budget the client approves, the purchase orders, the trade packages, the delivery schedule, the variation claims when something changes. If the takeoff is wrong, every one of those is wrong, and the error surfaces on site, which is the most expensive place to discover anything.

And here is the part that should bother anyone who has looked at it closely: on most residential projects the takeoff is done by a person, with a scale rule or a digitizer or a PDF measuring tool, reading the same blueprints the designer already worked from. The information was already in the drawing. It gets re-extracted by hand, usually more than once, because the contractor does not trust the consultant's numbers and the consultant does not trust the contractor's.

Why the numbers get measured twice

There are four reasons this keeps happening, and none of them are laziness.

  • The drawing is not machine-readable in a useful way. A PDF plan is lines and text. A CAD file is better but still needs interpretation about what is a wall, what is a finish, and where one material stops.

  • Nobody trusts a number they did not measure. Quantities carry commercial risk. A contractor who accepts someone else's takeoff has accepted their error.

  • Revisions do not propagate. The plan changes in revision C. The takeoff was built on revision A. There is no link between them, only a person who has to notice.

  • The visual and the quantity live in different tools. Rendering software cares about how something looks. Estimating software cares about how much there is. Very little sits in both worlds.

The result is a slow, duplicated process sitting between design approval and the first real cost number. It is the point where most residential projects lose the link between what the client agreed to and what actually gets bought.

Floor plan to bill of materials

The Indian version of this problem

In India the gap is sharper, not softer, and the reason is that Indian practice takes measurement far more seriously than most markets.

We already have a codified measurement standard. IS 1200, "Methods of Measurement of Building and Civil Engineering Works," published by the Bureau of Indian Standards, runs to many parts: earthwork, concrete, steelwork, plastering and pointing, painting and polishing, and more. It tells you exactly how a quantity is to be measured, what is deducted, and how it is expressed. The rules are not the problem.

What follows is the item-rate contract, the norm on a large share of Indian residential work. The bill of quantities is not an estimate that gets filed away. It is the contract. Quantities are measured before the work, remeasured at billing, and variations settled on measured quantity against agreed rates, often benchmarked to something like CPWD's Schedule of Rates. So every plan revision is not just a design event. It is a commercial event with a measurement attached.

Then there is RERA. Since the Real Estate (Regulation and Development) Act, 2016, an apartment in India has to be sold on carpet area, defined in Section 2(k) as the net usable floor area of an apartment, including the area under internal partition walls, but excluding external walls, service shafts, exclusive balcony or verandah and exclusive open terrace. Indian residential real estate now has a legally defined, unit-level net area concept that a buyer can hold a developer to.

Put those three together. India has strict definitions of what to measure, a contracting model where the measurement is legally binding, and a disclosure law built on a net area calculation. The actual numbers are still produced by a person with a measuring tool and a spreadsheet, reading the same floor plans the designer already worked from.

Add scale to that. An Indian developer building a tower is not building one home. They are building a handful of unit types repeated across hundreds of apartments. A small per-unit quantity error is the same error several hundred times, discovered at billing. Meanwhile the interiors and fit-out side often quotes per square foot, which is convenient for everyone and quietly buries the quantity question. The homeowner never sees what they are buying, only a rate.

A word about the rework statistics you have probably seen

I want to be careful here, because this is a topic where bad numbers circulate freely and I would rather lose an argument than repeat one.

Search for the cost of construction rework and you will find a figure around 5% of total project cost quoted constantly, usually traced to Construction Industry Institute research on industrial projects, sometimes with a range of 2% to 20%. Vendor-sponsored research from FMI and PlanGrid in 2018 went further, estimating approximately $177.5B in US labor cost spent on non-optimal activities in a single year, with more than $31B attributed to rework from miscommunication and bad data.

Now the complication. In January 2026, the American Society of Civil Engineers published a technical note on a study by Peter E. D. Love that measured actual rework costs from a contractor's own records rather than estimating them. It found pre-completion rework averaging 0.38% of contract value, rising to approximately 0.76% when postcompletion corrections were included, and found rework under-reported by 300%. It also noted earlier estimates running as high as 12.4% of contract value when change orders and quality issues were bundled together.

The industry does not agree with itself, by more than an order of magnitude, on how much rework costs. Definitions differ, project types differ, and so do the incentives of whoever is publishing.

So I am not going to build a business case on a rework percentage, and you should be suspicious of anyone who does. The argument for connecting design to procurement is not a statistic. It is structural: the same information is being produced twice, by hand, and the two copies are allowed to disagree.

An accurate 3D model is already a measured object

Here is the shift in thinking.

Most people treat a 3D visual as a picture. It is not. If the geometry is locked to the drawing rather than loosely inspired by it, the model is a measured object that happens to be viewable. It already contains, by construction:

  • Every wall, with length, height and thickness

  • Every floor and ceiling plane, with area

  • Every opening, so wall paint area can be computed net of doors and windows

  • Every door and window, counted and dimensioned

  • Every product placed in the space, if those products came from a real catalog rather than being invented by a generative model

That last point separates a useful model from a pretty one. If a render shows a sofa that does not exist, you have an image. If it shows a specific product with a real identity, you have a line item.

A tool that produces a beautiful room from a prompt has produced marketing. A system that can convert floor plan to 3D with geometry matching the plan, and populate it from a constrained catalog, has produced something you can count.

Put differently: AI 3D visualization that is spec-accurate is not a rendering feature with a measurement bonus. It is a measurement system with a rendering output.

What changes for each side of the table

WhoThe problem todayWhat a measurable model changes
Interior designersThe client approves a visual; the budget is built separately and comes back higherThe approved visual and the materials list come from one source, so the conversation about cost happens against the design the client actually chose
Residential developersUnit-type quantities are re-measured per tower, and small per-unit errors multiply across hundreds of unitsQuantities scale with the unit type; a change to one type propagates to every instance of it, and net areas can be computed on a consistent basis
ArchitectsRevisions break the takeoff silently, and nobody finds out until procurementThe model is the plan; if the plan moves, the quantities move with it
ContractorsNo trust in someone else's numbers, so everything is measured againA takeoff traceable to specific geometry can be audited rather than repeated

The common thread is not speed. It is traceability. Every number points back to a wall, an opening or a placed product, which is exactly what a takeoff has never offered.

Where this is genuinely hard

I am not going to pretend this is solved, by us or anyone.

  • Geometry accuracy is the gate. If the model's walls are approximately where the plan's walls are, the quantities are approximately right, which in procurement means wrong. Getting blueprint to 3D conversion accurate enough to measure from is the hard part, and it is the reason most AI interior design tools cannot go here at all.

  • Product identity is a second problem. A quantity needs a SKU, not a vibe. This is where most AI interior décor tools hit a wall: a beautifully generated lamp that does not exist has no code, no price and no lead time. It means a constrained catalog, not open-ended generation.

  • Waste factors are local knowledge. Tile cut loss depends on pattern, room shape and the tiler. A model can give you net area. Turning net area into an order quantity still needs a human rule.

  • Measurement standards are not universal. India measures to IS 1200. Other markets use their own rules for what gets deducted and how work is packaged and billed. A model can produce honest net geometry. Which convention that geometry is billed under is a local question, and it has to stay configurable rather than baked in.

  • Price data is a separate business. Knowing you need 42 square meters of a specific tile is not the same as knowing what it costs in Pune this month.

Anyone who tells you they have collapsed all five of those into one button is selling something. The realistic near-term version is narrower and more useful: get the geometry and the product list right, produce net quantities, and hand them to the people who already own the waste factors and the prices.

What Foursite does today, and what it does not

Being direct about this, because I would rather you trust the next thing I write.

Foursite today converts 2D floor plans and architectural drawings into interior design photoreal renders and walkthroughs, with the geometry locked to the drawing. It handles 2D to 3D conversion, styling, materials and AI virtual staging for unbuilt and vacant inventory. That part exists and you can use it.

It does not export quantities, areas or a bill of materials. That capability is on our roadmap, not in the product. I am writing about it because it is the most interesting thing the underlying engine makes possible, not because you can buy it this quarter. If anyone describes it as a shipped Foursite feature, including us, correct them.

Remodroom, which redesigns an existing room from a photograph, sits outside this argument. A photo-based redesign is not a measured object, and I would not want anyone ordering tile off one.

Why this is the interesting layer

Step back from the workflow and look at where the value sits.

3D Visualization as marketing output is a real business, but it is a cost line for the people buying it. Something that produces the procurement number is not a cost line. It sits in the operating path of the project, next to the budget, the purchase orders and the schedule. Products that sit there are much harder to remove.

For context, third-party research from Grand View Research puts the AI in interior design market at approximately $3.28B in 2025, growing to approximately $15.0B by 2033, a compound annual growth rate of roughly 20.9%, with the residential segment fastest at about 22.0%. Those are approximate third-party projections, worth verifying at source, and they describe only the design-visualization slice. The procurement and materials spend those designs commit is a far larger number, and it is the one that moves when a design decision changes.

That is the whole thesis in one line. AI visualization is where the decision gets made. Procurement is where the decision gets paid for. Right now nothing connects the two, and whatever connects them stops being a design tool and becomes part of how residential projects are run.

The practical version

You do not need to wait for anyone's roadmap to close part of this gap. Three things help immediately:

  • Put the revision number on both the approved visual and the priced list. It sounds trivial. It catches a surprising amount.

  • Specify real products, not categories. "Warm oak flooring" cannot be procured. A named product with a named finish can. This is the single biggest thing separating AI interior decor output that is decorative from output that is operational.

  • Do the visual before the takeoff, not after. If the client is going to change the tile, better that happens before somebody has priced the wrong one.

The direction of travel is clear enough. Interior design 3D visualization started as a way to sell an idea. It is turning into the place where the specification lives. Once it does, the materials list is not a document anybody writes. It is a query.

The picture was never the point. The picture is just the part you can see.
